ITSM migration guide

Freshservice to HaloITSM migration guide: phases, timeline and tooling

Migration is worth it when ITIL maturity, governance needs or scope have outgrown what Freshservice absorbs without workarounds. Most data transfers cleanly; the value is created in what gets rebuilt. Expect 8 to 16 weeks for a mid-market ITIL scope.

Updated June 2026 · SMC Consulting · ITIL v4

When a migration is worth doing

  • ITIL maturity has outgrown the defaults (change, multi-team routing, audit trails require workarounds).
  • CMDB reliability and asset lifecycle are becoming decisive for incident resolution.
  • Microsoft-native integrations (Entra ID, Teams) are now business requirements.
  • Three-year TCO keeps climbing through higher tiers, add-ons or paid AI.

When it is not

If your scope stays core ITSM (incident, request, knowledge, portal) with light governance needs, if time to value within 4–6 weeks is non-negotiable, or if internal capacity for an 8–16 week programme is not available — optimising your current configuration is often the better answer.

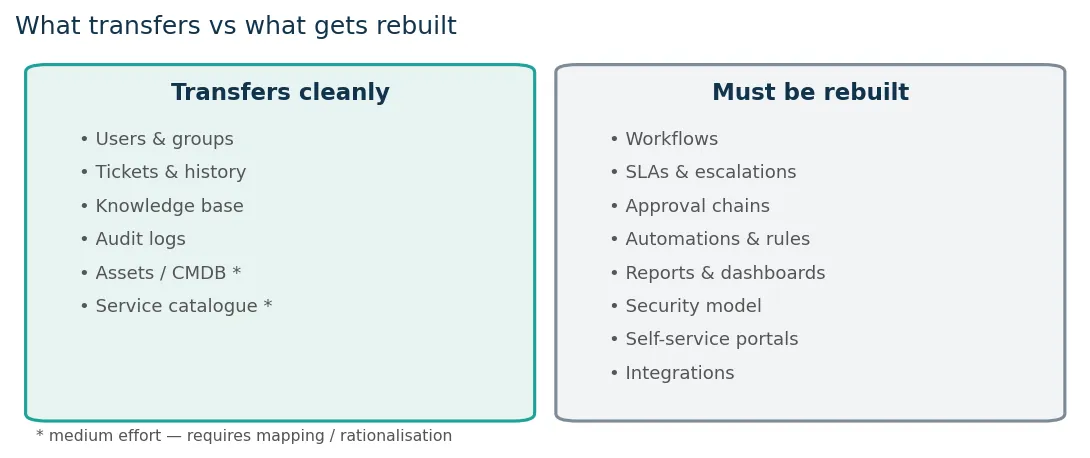

What transfers cleanly vs what must be rebuilt in an ITSM migration
Most data transfers; platform-specific logic gets rebuilt.

The 4-phase methodology

We structure migrations in four sequential phases, ordered so the riskiest unknowns surface before the team commits to build.

Indicative timeline of a 4-phase ITSM migration over 16 weeks
Indicative timeline (mid-market). Scope matters more than size.
ProfileTypical durationScope
Small deploymentAround 8 weeksUp to ~10 agents, IT-only, standard ITIL
Medium deployment8–16 weeks10–30 agents, structured CMDB, 5–10 integrations
Enterprise16+ weeks, phased30+ agents, multi-entity, deep CMDB/ITAM, possible ESM

Want it done with you? Our ITIL v4 consultants run these four phases alongside your team: plan your Freshservice to HaloITSM migration with us.

Trusted by leading organisations

Brussels Airport
ING
CPH Banque
DKV
Lotto
BNP Paribas Fortis
AXA
KBC
Proximus

Frequently asked questions

How long does a Freshservice → HaloITSM migration take?

For a mid-market organisation with a clearly scoped IT deployment, expect 8 to 16 weeks. Multi-department enterprise service management migrations run longer and are best phased.

What transfers and what gets rebuilt?

Transfers cleanly: users, tickets and history, knowledge base, audit logs (standard effort); assets/CMDB and catalogue (medium effort). Must be rebuilt: workflows, SLAs, approvals, automations, reports, security model, portals and integrations — that is where the value of the migration is created.

Should I migrate, or optimise what I have?

Start with optimisation: a focused configuration review is faster, cheaper and lower-risk than a migration. If it does not move the needle, the case for migration becomes clearer and more defensible.

What is the main risk in a migration?

Treating it as a technical project rather than a service transformation — the new platform ends up configured to mimic the old one and the strategic value is lost. The five major risks (data quality, complex workflows, integrations, adoption, change management) are mitigated by scoping in week 1.
